Find available resources for Project X

For every task of a project that is not yet fully staffed, the candidates with availability, free capacity, cost and schedule conflict.

All people, companies and projects shown are synthetic Rillsoft sample data – from the shipped industry packages or, where stated, from a test project.

The prompt

Find available resources for the project "ERP-Modul Rechnungswesen" (ERP module accounting): which tasks are not fully staffed yet, and who fits each of them?

Read-only mode is enough Licence-dependent function

In your words

  • Engineering consultancy: Which work stages of the new administration building have no person yet, and which specialist planners are free?
  • Mechanical engineering: Who can take over the open design tasks of the assembly line?

What you need

  • An open project with roles on its tasks.
  • Read-only mode is enough.
  • The candidate list is licence-dependent like the role column in the task dialog.

What you get

In the sample package IT service provider (portfolio) the project ERP module financial accounting is fully staffed – as shipped, the answer names no open task. The example therefore withdraws one of the four backend developers in January: Rushton takes over “Migrate and check the legacy stock” in the document management system (13 to 26 January 2027) and drops out of the ERP module.

After that the answer names two tasks with an open balance: “Sprint 3 banking and payroll interfaces” (6 January to 1 February, three of four backend developers, −80 hours) and “Extract and cleanse the legacy data and implement the migration rules” (6 to 26 January, one of two, −120 hours). The candidates are the four backend developers with cost rates of 76 to 80 – none has free capacity: Redmayne and Rothwell are on sprint 3, Sandiford is already assigned, Rushton works on document management; Redmayne is available only 40 % in this period anyway. No candidate from the pool closes the gap, only rescheduling or subcontracting. The three changes are undo steps in the session; nothing is saved.

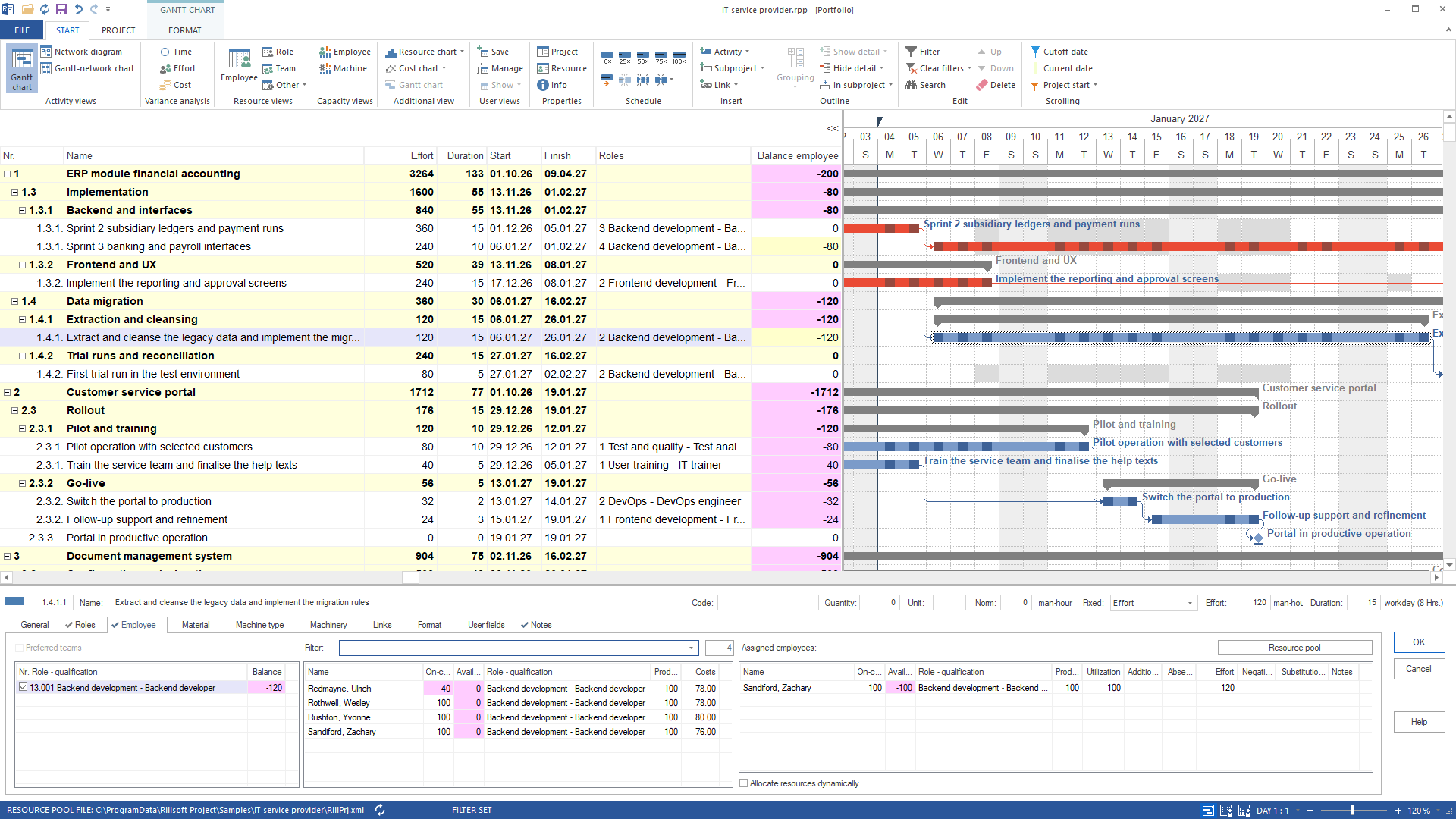

Gantt chart of the IT service provider portfolio, January 2027 on a daily scale, column employee balance: Sprint 3 banking and payroll interfaces −80, Extract and cleanse the legacy data −120; below the properties of the legacy data task, tab Employee: role Backend development with balance −120, candidates Redmayne, Rothwell, Rushton and Sandiford with availability 0 and costs 76 to 80, only Sandiford assigned
Rushton withdrawn in January: sprint 3 and the legacy data migration are open, and none of the four backend developers has free capacity in the period

Why it is useful

The list replaces clicking through every task dialog. Seeing the tasks without a free candidate first tells you where rescheduling or subcontracting becomes necessary. Without balance and schedule conflict from the plan the list would be an address book – who is free is only known after the comparison with the other tasks.

How the answer is produced

The AI reads the project tree, requests the candidate list for all tasks of the visible view and summarises per task. Demand and balance come from the scheduling engine of Rillsoft Project.

rillsoft_task_resource_candidate_list rillsoft_project_tree_get

Limits

Schedule conflicts are detected within the open project only. If the licence function is missing, the tool returns an error instead of an empty list. Nothing is staffed by this prompt. How to check whether a gap lies in the skill or only in the site is shown by the example staff across sites. The Rillsoft Project product page describes the candidate list.

Try it

Get started
Industry package
04_it_dienstleister
Product version
Rillsoft Project 10 (Build 10.0.623)
Last verified
2026-09-27
Verification
Figures and statements verified on the named sample package against the named product build – MCP session, view and report; German and English package with identical figures.
