The prompt
Compare demand with available capacity by week for the next eight weeks, per skill.Changes the project (one undo step)
In your words
- Mid-sized company: How do demand and supply for assembly and warehouse logistics look week by week in January?
- Public sector: Is site supervision sufficient when all four measures run in parallel in January?
What you need
- An open project or portfolio.
- Read-only mode is not enough: the AI switches the capacity view, the display and the weekly scale – one undo step each; project data stays untouched.
What you get

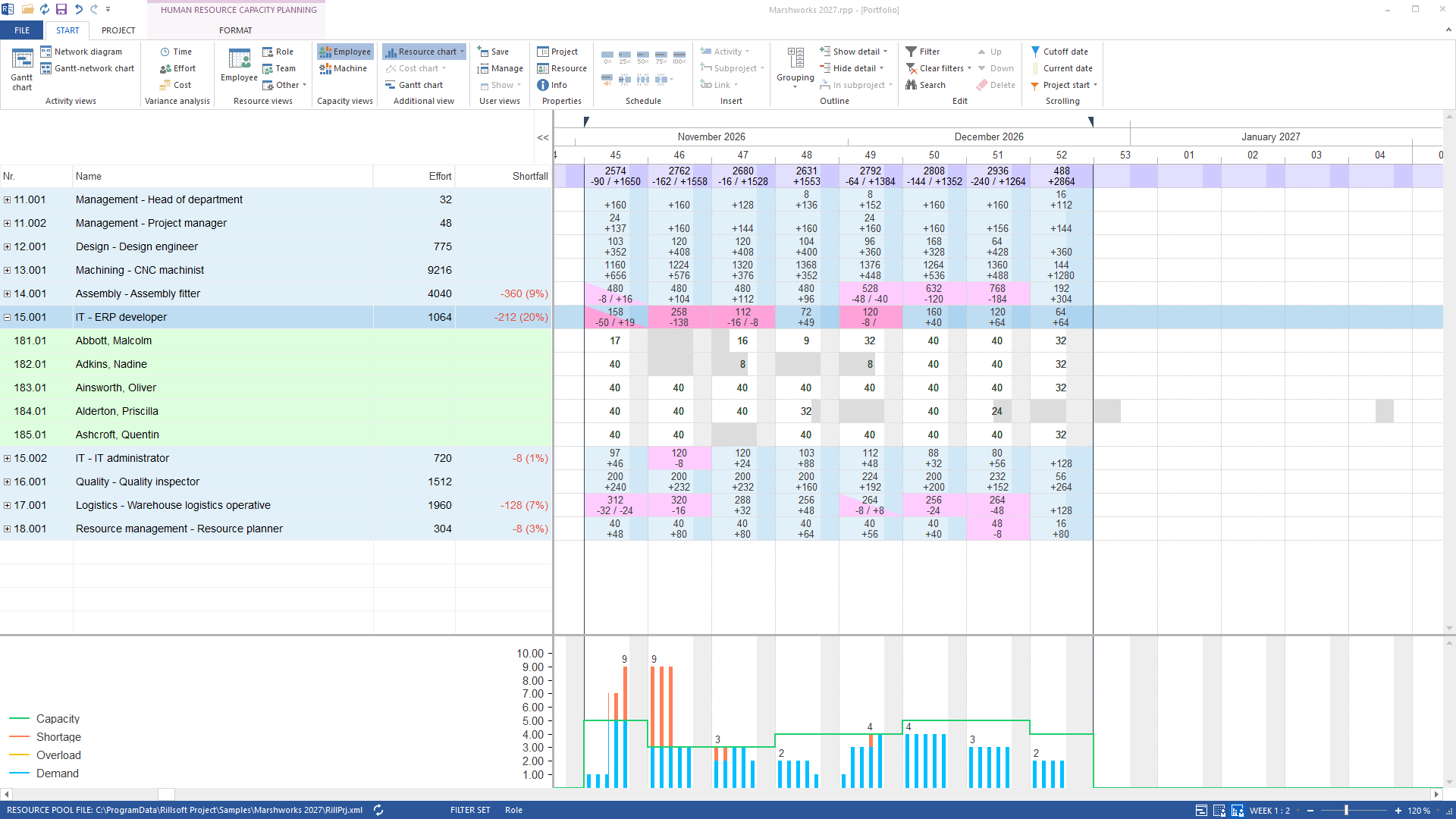

In the sample package Marshworks 2027 (portfolio) the answer returns per skill and week the demand, the supply of the associated people and the difference – in hours. Eight weeks from 2 November 2026: ERP developer (five people, three of them in that week) needs 258 hours against 120 available in the week of 9 November; Assembly fitter runs above capacity from early December (528 against 488, 632 against 512, 768 against 584 hours), Warehouse logistics operative just above. In January, Assembly fitter (808 against 608) and Warehouse logistics operative (up to 384 against 280) remain short.
Why it is useful
The table is the document for the capacity meeting: not “it is getting tight” but – as a sample sentence – “in week 3, 24 hours of assembly are missing”. Rillsoft Project delivers the cell, the AI the table; it can go straight into a template.How the answer is produced
The AI sets the capacity view to skill with absolute display, weekly scale and time filter; the report contains demand per cell and supply per person. The AI derives the difference from the report, not from the plan itself.rillsoft_view_state_apply rillsoft_timescale_apply rillsoft_analysis_report_get
Limits
Supply counts skill capacity, not heads. Percentages come from the same view in percentage display. Without a time filter the whole project period applies. The Rillsoft Project product page describes capacity planning.Try it
Get started- Industry package
05_mittelstand- Product version
- Rillsoft Project 10 (Build 10.0.623)
- Last verified
- 2026-09-27
- Verification
- Figures and statements verified on the named sample package against the named product build – MCP session, view and report; German and English package with identical figures.
