Which skills are missing for the scheduled work? Show me the tasks with an open balance per role.Read-only mode is enough
In your words
- Mechanical engineering: Which roles of the "Montagelinie MX-200" (assembly line MX-200) are not fully staffed with people?
- Construction: Where are bricklayers or concrete workers still missing on the shell construction tasks?
What you need
- An open project with roles on its tasks.
- Read-only mode is enough for the list; assigning staff first, as in the example, is a change – one undo step.
What you get

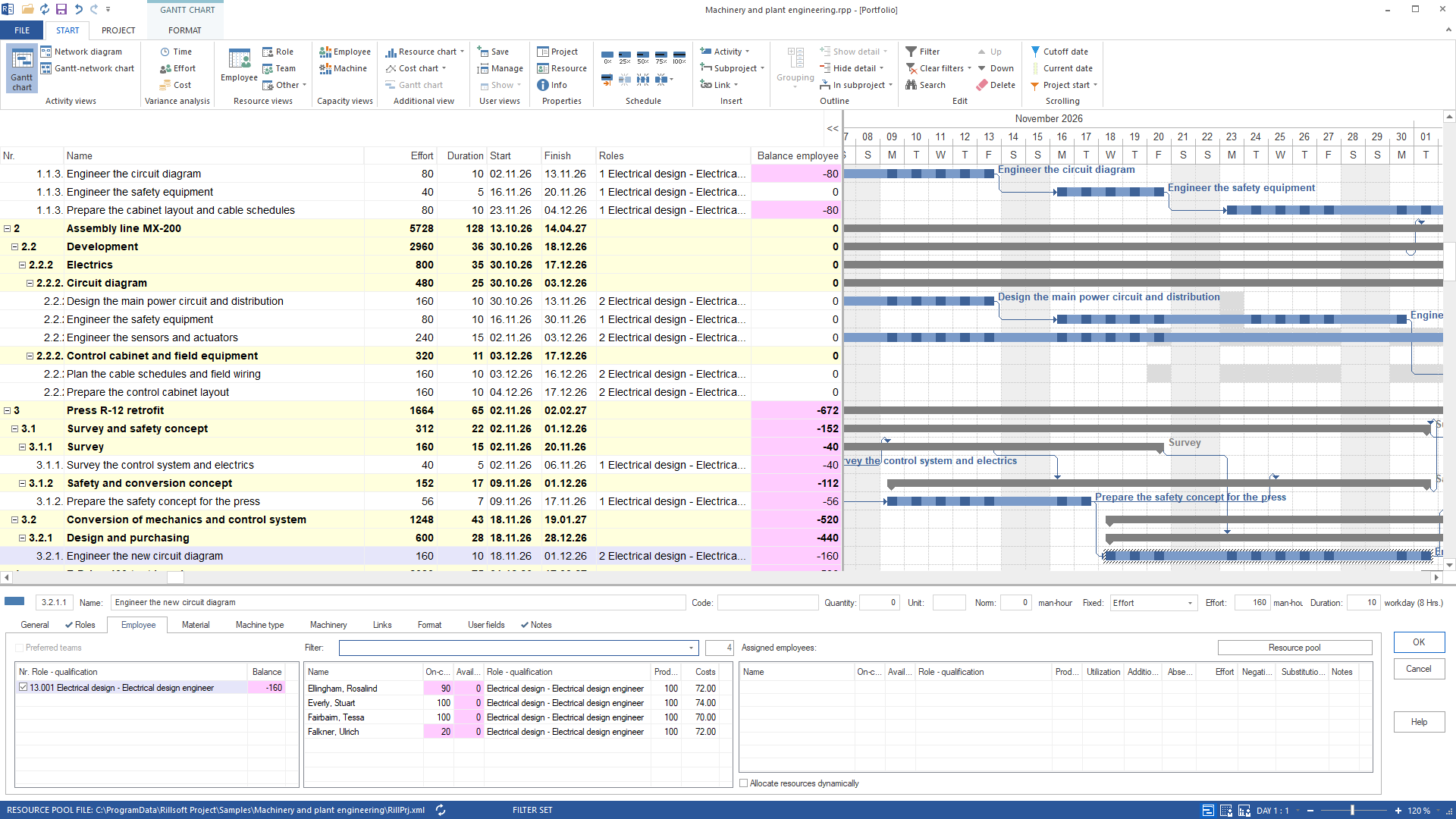

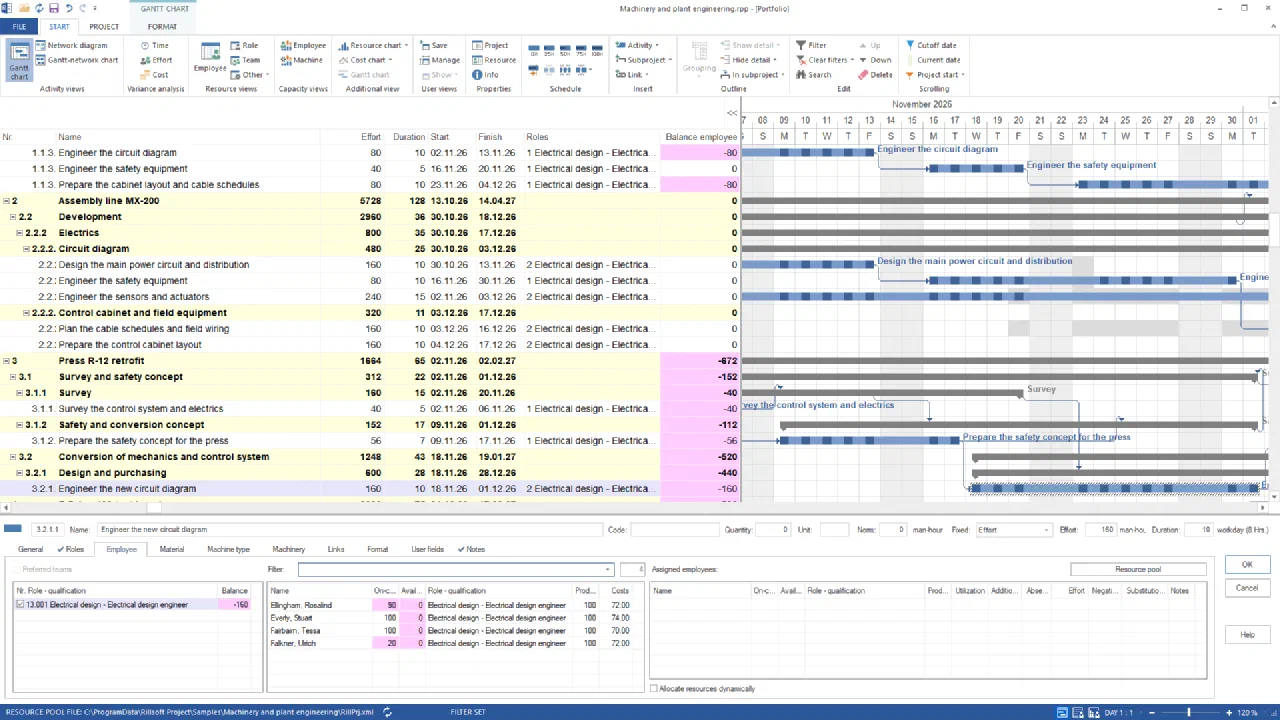

In the sample package Machinery and plant engineering (portfolio, five projects) four projects are planned with roles only. As shipped, 89 tasks with 22,776 hours are in the conflict list “Unassigned resources” – which only says that nobody has been assigned yet. The example therefore first runs the “Assign staff” wizard over all tasks: it assigns 81 people who are fully available in the task period. What remains open afterwards answers the question.
In the four projects it is 24 tasks with 1,832 hours, led by electrical design with seven tasks and 576 hours: circuit diagrams and safety concept of Packaging cell P-80 and Press R-12 retrofit in November, power electrics and measurement of the E-Drive 400 test bench around the turn of the year. The four electrical design engineers work on the circuit diagram of Assembly line MX-200 at the same time. Mechanical design follows (3 tasks, 400 hours), then mechatronics (3, 296), assembly fitters (3, 240) and purchasing (3, 200). On top come 18 base-load tasks of Service and small orders of one quarter each (12,696 hours), for which nobody is free for the whole quarter. The assignments are one undo step in the session; nothing is saved.

Why it is useful
A missing skill is the cause, a schedule slip the effect. Seeing the open balance per role early allows training, borrowing or postponing before the task starts. A list of tasks shows who is entered – the balance per role shows how many hours nobody carries.How the answer is produced
The AI reads the two conflict lists of the info panel as a report and orders the tasks by role and start. Rillsoft Project shows the same lists in its info panel.rillsoft_project_conflict_list rillsoft_project_tree_get rillsoft_task_resource_assignment_fill
Limits
A task with a negative balance and a person already assigned appears in both lists; the AI merges it by UUID. The balance applies to the open project, not to the pool as a whole; the shortfall per skill is the view of the capacity view. The Rillsoft Project product page describes roles and balance on the task.Try it
Get started- Industry package
02_maschinenbau- Product version
- Rillsoft Project 10 (Build 10.0.623)
- Last verified
- 2026-09-27
- Verification
- Figures and statements verified on the named sample package against the named product build – MCP session, view and report; German and English package with identical figures.
