The prompt
What happens in the ERP project if data migration starts two weeks later? Name the shifted follow-on dates, the new finish date and new conflicts – and take the change back afterwards.Changes the project (one undo step)
In your words
- IT services: Does cutover move if test and acceptance start two weeks later?
- Construction: What does a later shell start do to the interior works in winter?
What you need
- An open project or portfolio; in a portfolio subprojects can be shifted, only whole projects cannot.
- Read-only mode switched off.
- Every step is an undo step in Rillsoft Project.
What you get
In the sample package IT service provider the shift is refused at first: the milestone “Migration trial run passed” is fixed and would have to move from 16 February to 2 March 2027.

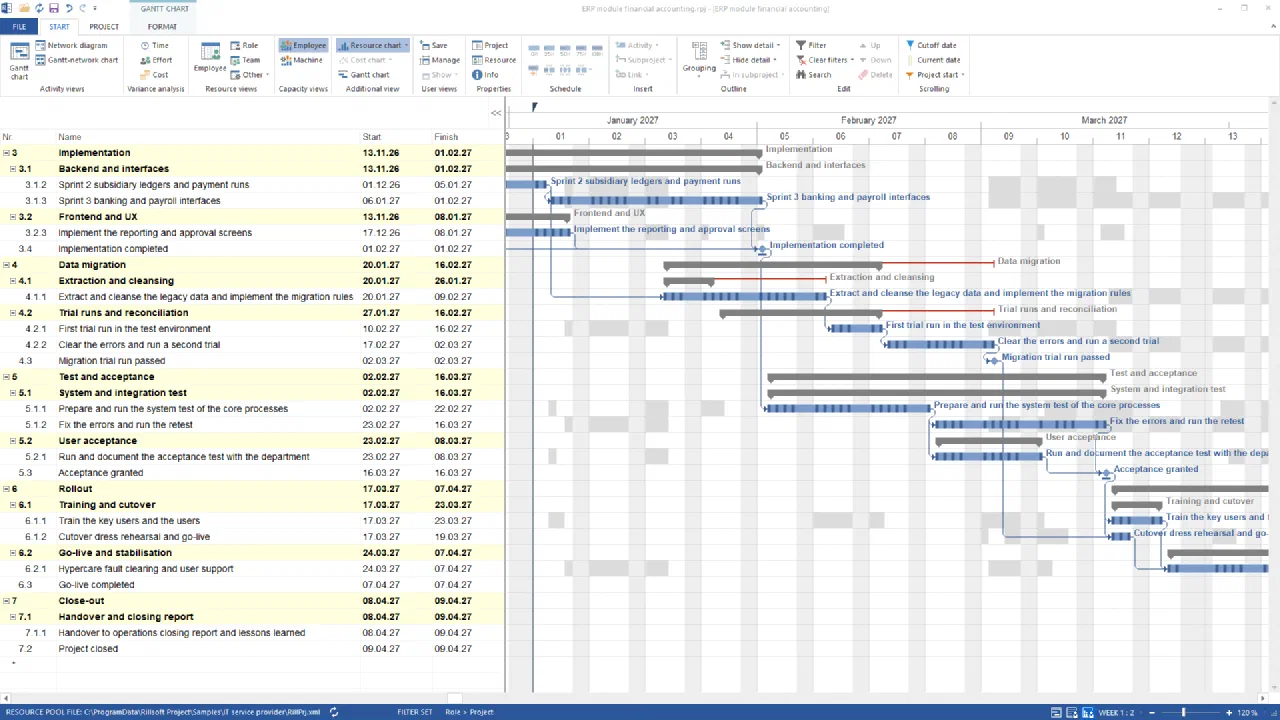

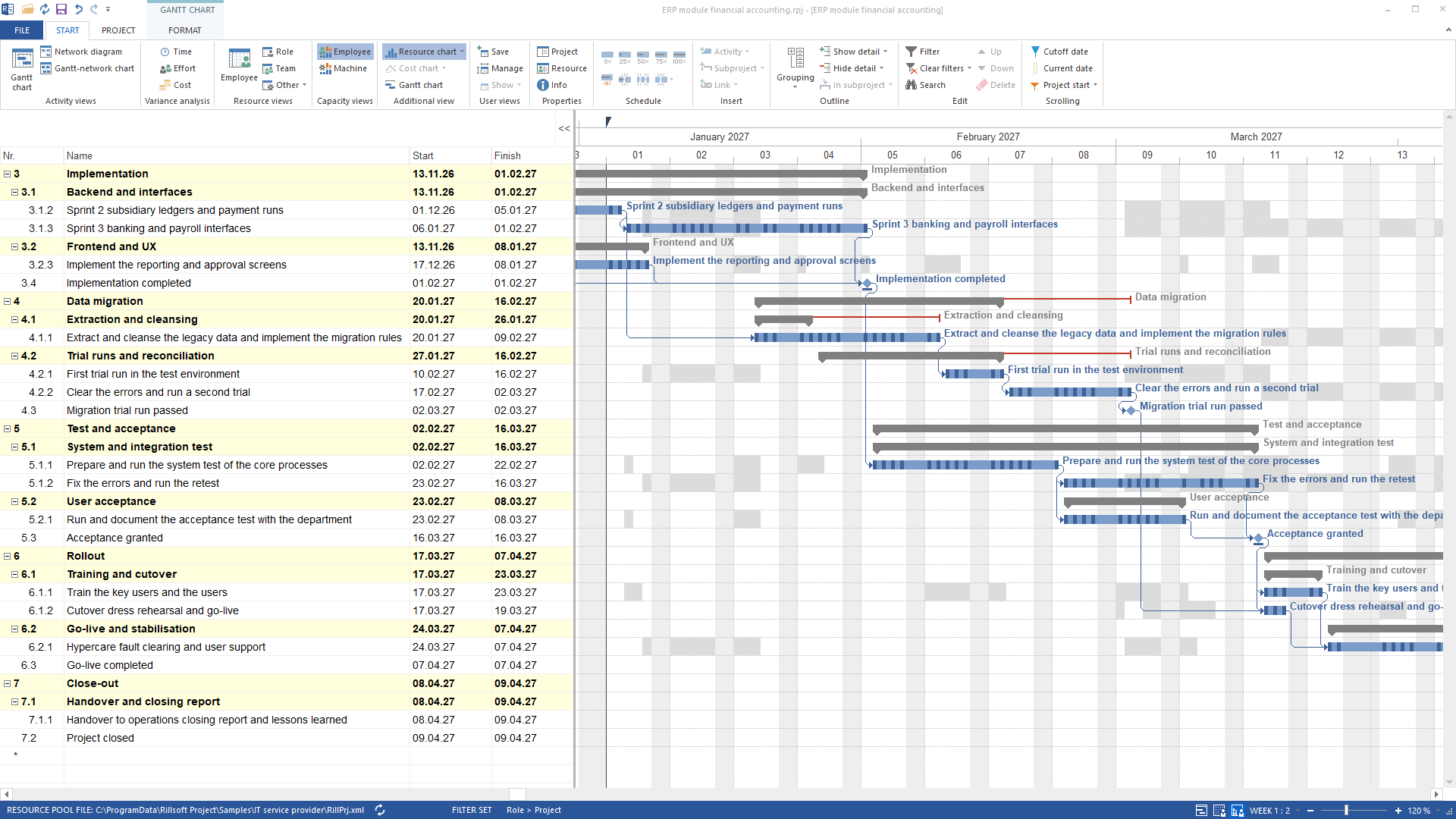

The answer releases the fixing, moves the subproject Data migration to 20 January, reschedules as early as possible and reads the tree and the conflict lists: three tasks and the milestone move by two weeks; the finish date 9 April holds because test, rollout and close-out are fixed; the January overloads of two backend developers disappear while a new one appears from 23 February to 2 March (six working days at 200 %). Four undo steps restore the starting state.

Why it is useful
The question comes from the steering meeting and wants an answer in minutes. The original stays untouched because every step is undoable. Moved by hand, a date moves; here follow-on dates, finish date and conflicts move with it – and back.How the answer is produced
Change the subproject, schedule the project, read tree and conflicts, undo. Dates are computed by Rillsoft Project; the AI describes the difference to the starting state.rillsoft_task_update rillsoft_subproject_update rillsoft_project_reschedule rillsoft_project_conflict_list rillsoft_history_undo
Limits
Fixed and started tasks stay put. Shifting a whole project inside a portfolio is not possible; open the single project for that. File and session operations are not undo steps – so this prompt saves nothing. The Rillsoft Project product page describes scheduling and undo.Try it
Get started- Industry package
04_it_dienstleister- Product version
- Rillsoft Project 10 (Build 10.0.623)
- Last verified
- 2026-09-27
- Verification
- Figures and statements verified on the named sample package against the named product build – MCP session, view and report; German and English package with identical figures.
